|
Transmission Line Right of Way Use
Guidelines
Progress Energy’s goal is to provide safe, reliable and economical
electrical service to all customers. Keeping electricity reliable requires
unobstructed access for maintaining power lines, facilities and rights
of way. The following list has been developed to provide landowners and
other interested parties with a guide for the use of Progress Energy’s
transmission line rights of way. If you wish to use a Progress Energy’s
transmission right of way, please contact a Progress Energy Encroachment
Representative concerning any proposed plans.
The guidelines presented below should be used in planning every project.
However, compliance with these guidelines should not be construed as
permission to use Progress Energy property without a written agreement
executed by Progress Energy. Applicant(s) will be held to the guidelines
in effect at the time the application is received by Progress Energy.
The guidelines are subject to change without prior notice. For
easements acquired by condemnation, not all of the guidelines may apply.
Progress Energy does not guarantee your requested use to be completely
compatible with the safe and efficient operation and maintenance of Progress
Energy’s existing and future high voltage electrical lines. Any
remedial action required to resolve a subsequent conflict will be at
your sole cost and expense.
Progress Energy transmission rights of ways contain high voltage power
lines. Extreme caution must be used when working in the right of way.
If you have any questions regarding the Transmission Right of Way Use
Guidelines, please contact a Progress Energy Encroachment
Representative.
- Structures (any
man-made assembly), Equipment and Storage - Under limited
circumstances, a structure, piece of equipment or storage may be allowed,
with prior written approval from an authorized Progress Energy Encroachment
Representative -- if they meet all of the following criteria:
a. Is temporary and is easily and
immediately movable at owner’s expense.
b. Does not restrict complete access and
maintenance of line or right of way, or future use by Progress Energy.
c. Does not adversely affect the
safety of customers, company personnel or the general public.
d. Is not located under and at least fifteen
(15) feet beyond the outer most conductors and does not exceed twelve
(12) feet in height.
e. Is not located any closer than fifty (50) feet from any
transmission pole(s) and anchor(s) or any closer than seventy-five (75)
feet from any transmission tower(s).
Structures, equipment and storage include, but are not limited to,
the following: buildings, sheds, storage facilities, trailers, signs,
street or area lights, hunting stands, recreational facilities, dumpsters,
satellite signal receiver systems, items within storage facilities, garbage,
trash, uprooted stumps, boulders, rubble, flammable material, building
material, and junk or inoperable vehicles. Permanent or non-movable
buildings, swimming pools, mobile homes and airstrips are not allowed
within Progress Energy’s rights of way.
- Immovable Ground
Facilities - Under limited circumstances, immovable ground
facilities may be allowed, with prior written approval from an authorized
Progress Energy Encroachment
Representative, if they meet all of the following criteria:
a. These facilities must cross the
centerline of Progress Energy’s transmission line at an angle
of forty-five (45) degrees or greater and the edge of the item is at
least fifty (50) feet from Progress Energy structures and fifteen (15)
feet from anchors.
b. All underground facilities must not
extend above surrounding grade, and must be capable of supporting the
vehicle loading described in the section on Pipelines below.
c. Manholes must
not extend above surrounding grade and must be capable of supporting
the vehicle loading described in the section on Pipelines below.
d. Fire hydrants, utility pedestals,
or any other above ground facilities shall not be allowed directly
under conductors or within fifteen (15) feet of the outer most conductors.
Immovable ground facilities include, but are not limited to,
the following: streets, roads, driveways, water and sewer lines, ditches
and any underground facilities. If during the construction of facilities,
a customer cuts or damages the counter poise/grounding grid, the customer
must reimburse Progress Energy for the cost of repairs.
Septic tanks and/or related drain fields, absorption pits, wells, burial
grounds, and underground vaults are not allowed within Progress Energy rights
of way.
- Pipeline projects
(fuel, natural gas, storm sewer, sanitary sewer, water, etc.) are subject
to a $12,000 preliminary review fee, plus the review
consultant's fee based on the type of product carried in the
pipe, the size of the pipe, and length of the pipe in the right of
way. The Encroachment Representative will review your project plans
to preliminarily approve the location of the pipeline within the
right of way. Your application must include plan and profile drawings,
cross sectional drawings depicting the proximity of the pipeline
and any appurtenances to the existing electrical facilities, location
maps depicting names of major streets and intersections, and a list
of properties and easements owned by Progress Energy by county, section,
township and range and tax parcel identification number that are
involved in the project.
Underground pipeline facilities must comply with Progress Energy
Pipeline Collocation
Guidelines. Any exceptions to these guidelines must be granted
in writing by Progress Energy. In addition, all pipeline projects must
comply with the National Standards of Canada, specifically "The Principles
and Practices of Electrical Coordination Between Pipelines and Electric
Supply Lines" CAN/CSA-C22.3 No. 6-M91 prepared by the Canadian
Standards Association. Progress Energy requires all pipelines
to be installed in the outside five (5) feet of the right of way
and to have sufficient earth cover to prevent breakage due to the
operation of Progress Energy vehicles and heavy equipment in the
right of way. Progress Energy’s heaviest piece of equipment
has three (3) rear and two (2) front axles, twelve (12) rear and
four (4) front wheels and weighs one-hundred (100) tons when lifting
its maximum payload. In addition, all underground pipeline facilities
shall be designed to support crane outrigger point loads of seventy
thousand (70,000) pounds each. No work shall be performed by a dragline
or a cable type crane. Refueling activities are prohibited on the
right of way.
A pipeline interference study must be performed at applicant's sole
cost which will include a soil resistively analysis, inductive analysis,
steady state mitigation design, conductive analysis, gradient control
grid design and an AC
mitigation study. Additional supporting studies may be required
to properly evaluate the project and to ensure technical compliance
with Progress Energy’s collocation guidelines and the Canadian
Standards, the cost of which will be borne solely by the applicant.
Cathodic protection or other safety measures may also be required.
Applicant will be required to pay for all expenses incurred by Progress
Energy and its consultant during its review and safety evaluation of
the proposed underground pipeline facilities.
The applicant, at applicant’s sole cost, is required to provide
Progress Energy with an appraisal of the utilization area prepared
by one of Progress Energy approved appraisers. Contact the Encroachment
Representative in your project area for a list of Progress Energy’s
approved appraisers.
Upon receipt of the application, the $12,000 fee, and the consultant's
fee, Progress Energy may provide, upon request, voltage information,
present and future loads, fault current studies, conductor and OHGW
classifications, tower/pole configurations, spans between towers,
circuit drawings, and ground impedance of towers.
A final agreement will be prepared upon Progress Energy’s confirmation
that the proposed pipeline facilities comply with Progress Energy’s
collocation guidelines and the Canadian standards. No work may commence
in the right of way until a final agreement has been executed by both
parties. Applicant is required to pay Progress Energy for the costs
of hiring a Progress Energy approved inspector to be present during
construction activities. A minimum of four (4) to six (6) months will
be required to review your project.
- Parking Lots may
be constructed on Progress Energy rights of way with prior written
approval from an authorized Progress Energy Encroachment
Representative, and if they are in compliance with the following
conditions:
a. That the near edge
of pavement shall be setback a minimum of fifteen (15) feet from the
base of all poles, towers and anchors. Exceptions may be granted
on a case by case basis if applicant installs a barrier adequate to protect
the pole, tower or anchor from accidental vehicular impact. The
type and size of barricade shall be at Progress Energy’s sole
discretion and the costs are to be paid by applicant.
b. That the nearest drive
lane to the overhead conductors shall be a minimum width of thirty
(30) feet wide and run parallel to (in the same direction as) the transmission
lines to allow Progress Energy’s trucks and heavy equipment to
be able to utilize the drive lane(s) for routine and emergency access
to the overhead conductors.
c. No grade changes
are permitted within fifty (50) feet of Progress Energy’s poles,
towers and anchors without prior written approval.
d. No lighting facilities
are permitted within fifty (50) (feet) feet of Progress Energy’s
poles, towers and anchors or directly under the conductors. All
lighting facilities must maintain at least a fifteen (15) feet setback
from the outer most conductors and not exceed a maximum height of twelve
(12) feet above existing grade within the right of way. Exceptions
to the twelve (12) feet height requirement may be granted on a case by
case basis, at PEF’s sole discretion, if the Applicant places
the light structures at least fifty (50) feet away from the nearest
pole, tower and anchor and they are at least thirty (30) feet from
the outer most conductor.
e. Signs and other
attachments to any Progress Energy structure are prohibited.
- Grading will
not be allowed without prior written approval from an authorized Progress
Energy Encroachment
Representative. Any grading that interferes with Progress Energy’s
ability to perform routine maintenance or emergency access to its facilities
will not be permitted within the right of way. No grade changes are
allowed within fifty (50) feet of Progress Energy structures, towers and anchors
and any grading that allows water to pond or to cause erosion around any pole,
tower or anchor is expressly prohibited.
a. For general purpose
grading, changes in grade of more than two (2) feet, cut or fill, are
not permitted within the right of way; the maximum allowable slope
may not exceed a (1) foot rise/fall in elevation over a twelve (12)
foot horizontal distance (12:1 slope).
b.
For special purpose grading (drainage swales, outflow ditches and
raised berms) changes in grade of more than two (2) feet, cut or fill,
are not permitted within the right of way; the maximum allowable slope
may not exceed a (1) foot rise/fall in elevation over a five (5) foot
horizontal distance (5:1 slope).
Changes in grade of more than two (2) feet may be granted on a case
by case basis if the proposed grade changes do not violate the National
Electric Safety Code (NESC) and they not interfere with Progress Energy’s
ability to efficiently operate and maintain its facilities. Additional
changes in grade may be mitigated through the use of box culverts, stabilized
access ramps or dedicated access locations acceptable to Progress Energy. For
drainage ponds, see the Lakes section below. No grading work may
be performed by means of a dragline or cable type crane within the right
of way. If required by a permitting authority, it is the applicant’s
responsibility to perform an endangered/threatened species study prior
to the alteration of the terrain.
- Fences must
be installed at least ten (10) feet away from poles or towers and can
not exceed eight (8) feet in height. Fences may not be attached to Progress
Energy poles or towers. If Progress Energy’s ability to travel
up and down the right of way is impeded, the property owner must install
sixteen (16) foot wide gate(s) and be grounded according to Progress
Energy’s specifications. Each
gate may be secured with a chain and padlock, at the owner’s expense,
to facilitate the creation of an interlocking
padlock system with Progress Energy.
- Lakes, stormwater
ponds, erosion control facilities and dams that interfere with Progress Energy’s
access and/or maintenance requirements are not permitted. Unobstructed
vehicular access to the overhead lines, structures and anchors is required
at all times for routine maintenance and emergency repairs. Stormwater
ponds located within fifty (50) feet of Progress Energy’s poles, towers
and anchors or within forty (40) feet of the overhead conductors are prohibited. Lakes,
stormwater ponds, erosion control facilities and dams may be allowed in
the outer five (5) feet of the right of way with prior written approval
from an authorized Progress Energy Encroachment
Representative, if they do not interfere with Progress Energy’s
access and/or maintenance requirements. As early in the project as
practical, development drawings should be presented to the appropriate
Encroachment Representative for discussion. (See
Sample Project Drawing)

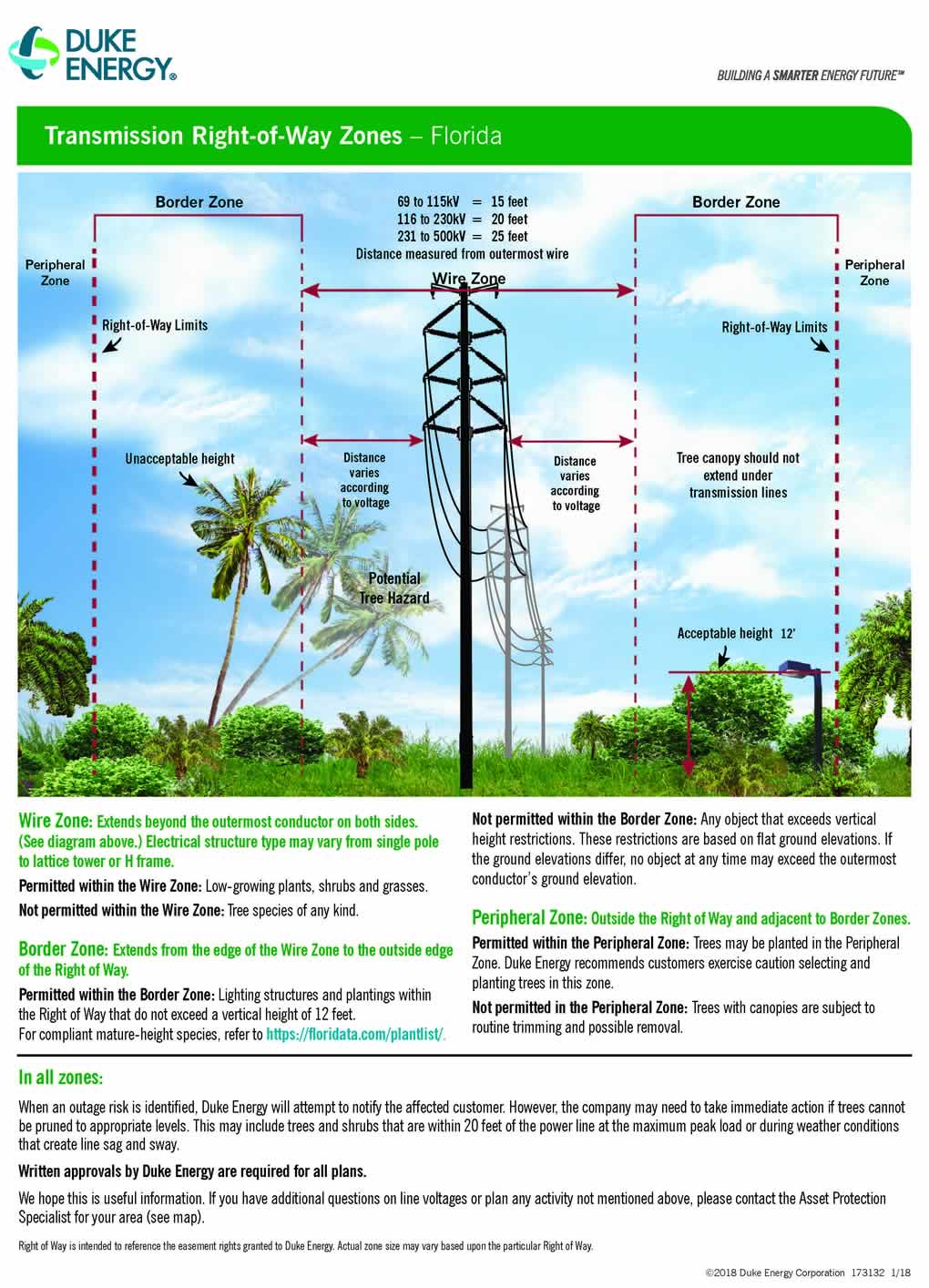

- Trees, shrubs, bushes,
hedges, low-growing evergreens, flowers, grasses, low-growing shrubs, gardens
or other vegetation may be allowed with prior written approval to be planted
within Progress Energy rights of way must not exceed a maximum height
of twelve (12) feet at maturity, and may not interfere with Progress Energy’s
access and/or maintenance requirements. (See
Approved Species List)
- No item shall be
allowed on Progress Energy’s rights of way that violates the National
Electrical Safety Code.
- No
burning activities are allowed in rights of way.
- No stock piling of dirt or materials are allowed in rights
of way.
- No refueling of any kind is allowed in rights of way
- Access to
electrical facilities for construction, repair, operation and maintenance
must be maintained at all times. An obstructed, level, and thirty (30)
foot wide accessway must be maintained adjacent to and underneath the
overhead conductors and to each transmission structure for Progress Energy
to perform routine maintenance and emergency repair.
- The Bartow Anclote
Hot Oil Pipeline is located in Pinellas County, Florida. Projects
located in the same right of way as Progress Energy’s Bartow
Anclote Hot Oil Pipeline must comply with Guidelines
for Construction Crossing of the B/A Oil Pipeline. If Progress Energy determines
your project increases the load over the hot oil pipeline, increases the environmental
risk of the pipeline or it potentially affects other public services in the
pipeline area, you will be required to encase the pipeline at your expense.
All work will be planned and performed by Progress Energy personnel.
Two additional sets of drawings showing the depth of the pipe and the
area of the proposed construction must be provided with the initial application.
Progress Energy will prepare a time and cost estimate and you must enter
into an Authorization and Agreement Contract for the work. Full payment
of the contract is due prior to commencing work.
- Conservation easements are
fundamentally inconsistent with the requirements for the operation of an electric
transmission or distribution line. Conservation easements are not permitted
in the right of way
|
